TO: |
Mayor and Members of Council |
|
|
|
|
FROM: |
Catherine Biss, CEO, |
|
|
|
|
PREPARED BY: |
Deborah Walker, Manager, Library Strategy |
|
|
|
|
DATE OF MEETING: |
2004-June-14 |
|
|
|
|
SUBJECT: |
|
|
|
|
RECOMMENDATIONS:
THAT the report
“Markham Village Library Expansion” be received;
AND that
Council approve the Schematic Design of Option 4 for the Markham Village
Library expansion of 15,750 square feet and authorize the Architect, Shoalts
and Zaback, to proceed with the Detailed Design;
|
AND that Council approve the approximate size of this project as
follows:
New Construction 15,750 sq. ft.
Renovated Area 19,560 sq. ft.
Total 35,310 sq. ft.
AND THAT Council approve a Schematic Design cost estimate for the New
Construction, Replacement and Renovation as summarized below:
|
New Construction |
Replacement |
Renovation |
Total |
Construction |
$3,095,850 |
$1,294,309 |
$2,101,925 |
$6,492,084 |
Furniture, Fixtures
and Equipment, IT |
$741,405 |
|
|
$741,405 |
Collections |
$1,144,600 |
|
|
$1,144,600 |
Internal * |
$475,952 |
$293,088 |
$98,075 |
$867,115 |
TOTAL |
$5,457,807 |
$1,587,397 |
$2,200,000 |
$9,245,204 |
*Internal costs include: Architectural fees, signage, security,
insurance, & move-in expenditures
AND THAT Council approve the following funding sources for the 10,500
square foot of New Construction ($3,571,802) ($3,095,850 plus $475,952):
Previously approved capital proj.
(5155) $1,807,800
Development
Charges Reserve Fund $ 590,801
General
Capital Reserve $ 65,644
Non-Development
Charge Sources $1,107,557
Total New Construction $3,571,802
AND THAT Council approve the 5,250 square foot
Replacement project cost estimate of
$1,587,397 to be funded from the offset of the operating lease for a
period of approximately 6 years;
AND THAT Council approve the Renovation project cost
estimate of $2,200,000 to be funded in two phases. One half of the cost ($1,100,000) was
included in the 2004 budget, and the remaining $1,100,000 is to be included in
the 2005 (tax-funded) capital budget;
AND THAT the Mayor and Clerk be authorized to
amend the architectural services contract based on the proposed increased scope
of the building program in a form satisfactory to the Chief Administrative
Officer and to execute the architect’s agreement;
AND that staff provide a detailed cost estimate for Council approval
upon completion of the Detailed Design;
AND that Council approves the
extension of the Library Administration Centre lease to October 2006;
AND FURTHER that Council approves the schedule detailed below with an
opening date for the project of October 2006:
Activity |
Target Completion Date |
Council Approvals |
Schematic Design |
July
– August 2004 |
September 2004 |
Design Development |
September
– October 2004 |
|
Construction Documents |
November
2004 – March 2005 |
|
Tendering |
April
– May 2005 |
June 2005 |
Construction: Phase 1 New |
July
2005 – March 2006 |
|
Construction: Phase 2 Renovation |
April
2006 – September 2006 |
|
Opening |
October
2006 |
|
PURPOSE:
The purpose of this report is to obtain Council approval
for the Schematic Design of
Option 4 of the Markham Village Library Expansion and authority to proceed with
the Detailed Design of this project.
BACKGROUND:
Option 1 –
Expansion to South
Option 1 proposed a 10,500
square foot expansion to the Markham Village Library. The expansion site was to the South and
required a full basement which would not be used by the Library. A business case was made to move the Markham
Library Administration to this empty basement. Through synergies with the Markham Village
Library, this made 5,250 square feet sufficient for the Administration, as
opposed to 8,500 square feet in a stand-alone location. Option One met the space needs of the Library
and also permitted significant use of DC charges.
However, through the community
consultation process, it became apparent that Option One did not meet the
community’s expectations and needs for the Library’s site.
Renovation of Existing Library
It further became clear that a renovation of the existing Library space
was necessary. Council approved $2.2
million for the renovation: $1.1 million each in the Town’s 2004 and 2005
(proposed) Capital Budget program.
Option
2 – Expansion to West
As part
of the preliminary site assessment process, the Architect developed a design
option that involved an expansion to the west of the existing Library. However, the public did not support Option 2.
Option
3 – Expansion to North
During
an extensive public process involving two public meetings, two workshops and
numerous interviews with community groups, there was overwhelming support for
the Library extension to the North, and for expanding the project into becoming
a “Community Gateway” project which would enhance the identity of the site as a
key Markham public resource. Allied to
this general consensus was the desire to maximize the interrelationship between
the Library and the Arena.
However,
Option 3 significantly exceeds the budget and program for the project.
Therefore, at the direction of the Executive Steering Committee, a
recommendation was made to a Committee of the Whole of Council, on March 9,
2004, that Option 1 should be adopted, since it met the Library’s space and
functionality needs and was a more cost-effective approach. Council deferred its decision and asked that the
Technical Advisory Committee explore funding and other alternatives to support
Option 3.
Library Board Supports Expansion to the North
On March
15, 2004, the Library Board passed a motion which supports the concept of the
Markham Village Library expanding to the north.
Option
4 – Expansion to North
At a
Finance and Administrative Committee meeting on March 22, 2004, staff were requested to further review Option 3 as the
preferred option. Also, 10 specific
points were to be reviewed and reported back to the Committee of the Whole (see
attached Appendix “A”).
Option 4
is a modified Option 3 and provides maximum opportunity for the future of the
Arena area and remainder of the site.
The Town has completed a study which indicates that the Arena has
approximately 10 to 15 years of useful life before significant investment is
required. It will, therefore, be
necessary to review options for the Arena area and remaining site area,
regarding both current and future uses.
Public input will be included in this future process for site
redevelopment.
Option 4 highlights:
· Has Library extensions similar to that
in Option 3 (10,500 sq.ft. public space and 5,250 sq. ft. to replace the
existing basement program rooms, for a total 15,750 sq. ft.);
· Provides for a possible link to the
Arena capable of being built in the future;
· Provides, as part of the Library
expansion project, a shade garden between the Library expansion and the Arena,
which customers could access from the Library and in which they could sit and
read;
· Recognizes that many future opportunities
can be accommodated for the Arena/ Arena site area.
Note
that Option 3 and Option 4 both propose
to not place the expansion against the Arena’s west wall for the
following reasons:
· It restricts future uses of the Arena
building;
· It compounds difficulties in producing
a functional library;
· It blocks 3 Arena fire exits.
Public Meeting, Wednesday, June
9, 2004
Staff presented the options outlined in this report to the Public at a
meeting on June 9, 2004. Approximately
20 members of the public attended this meeting.
Option 4 was generally well received by the public. If Option 4 is approved, the architect,
project manager and the Library will continue to consult the community on the
various issues raised at the meeting, including access for the disabled,
pedestrian access, vehicular access, drop-off points, the study of the Village
Green and Park, and the detailed design of the public meeting rooms. The future of the Arena and its site was also
discussed.
Option
4—Site Plan
The

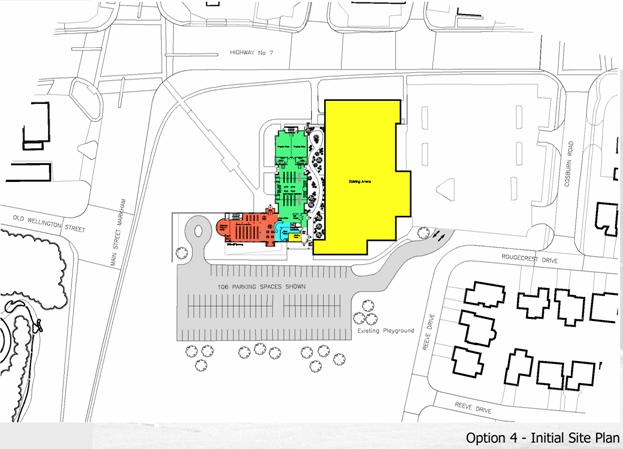

initial site plan for Option 4, based on the current alignment of Main
Street/Highway 48, is shown in the drawing below:
In the

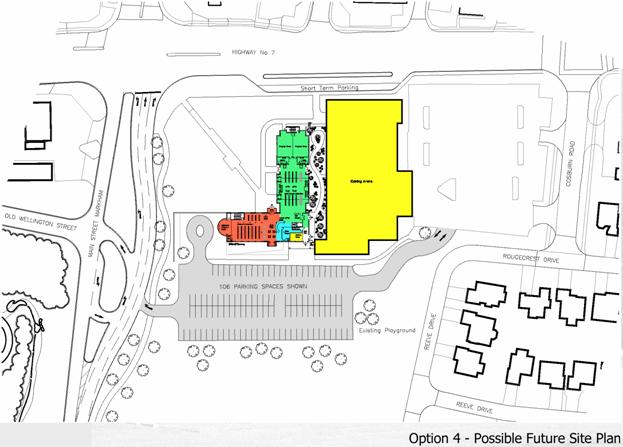

event of a realignment of Main Street/Highway 48 as envisaged in the Main
Street Markham Streetscape and Traffic Management Study, the Site Plan would be
adapted as indicated below:
Business Case for Moving Library Administration to the
Markham Village Library
Library Administration Centre Lease Expiring
The Library has leased 10,851 square feet of office space for the
Administration Centre (AC) at 445 Apple Creek Blvd, since 1990. Located at this facility are the
Administration, Acquisitions, Cataloguing and Computer Services Department
functions and staff.
The first ten-year lease expired on November 30, 2000, and the
Library exercised the option to renew for an additional three years. That 3-year lease expired on November 30,
2003. At that time, the term was
extended for a further term of 15 months, commencing on December 1, 2003 and
expiring on February 28, 2005, with an option to extend the term for three more
months, effectively to the end of May 2005.
To exercise this option, notice must be provided to the landlord by the
end of August 2004.
Council Approved Relocation of Library Administration Centre to the Expanded
Markham Village Library
On January 26, 2003, Library staff submitted a Report to the Finance
& Administrative Committee entitled “Cost-Benefit Analysis of Relocating
the Library Administration Centre within Markham Community Library Expansion”. The staff analysis and recommendation that
the AC be incorporated into the expansion of the Markham Village Library was
predicated on the concept of expanding the existing Library to the south, as
proposed by the 2001 Feasibility Study on the Markham Community Library
Branch Expansion and Conversion of the Existing Heating and Cooling System to
Central HVAC System. Due to site
grades, such an expansion would require an unfinished basement shell
space/foundation (DC-fundable) to support the two upper levels of the Library
expansion. Staff envisaged that this
unfinished basement space could be finished to accommodate the Library’s AC
functions and staff. Council received
the Report and recommended “that this project be incorporated into the
expansion of Markham Community Library”.
Expansion to North—Impact on Plan for Library Administration Centre
In response to community input, the design premise of the January 6,
2003 report (expansion to the south) changed.
Library expansion to the north is now the preferred option.
Expansion to the north can proceed as a slab-on-grade
construction. The relatively flat site
grades to the north of the existing Library mean that a basement is not
required to support the 10,500 sq. ft. expansion. The opportunity to finish an otherwise
unfinished basement space for the AC is lost.
To date, no other space has become
available in the Town for the AC relocation.
Accordingly, the cost/benefit analysis of
locating the AC at the Markham Village Library location was revisited. Under Option 4 (relocation of AC to basement
of existing building), the payback will be approximately 7 years – i.e. it will
take 7 years for the one-time expenses associated with relocating the AC to the
Markham Village Library to be offset by the annual cost savings resulting from
the AC not being in a leased facility.
Under Option 1 (relocation of AC to basement of expansion) , the payback was estimated to be approximately 1.96
years. A detailed breakdown of these
costs is included in Appendix “B”.
The estimated
one-time expenses associated with relocating the AC to the Markham Village
Library are $1,587,397.00. A detailed breakdown of
these costs is included in Appendix “C”.
Schedule for Move
from Leased Facility—Need to Extend AC Lease
Under Option 1, it
was envisaged that the AC would move into the basement of the expansion as soon
as new construction was completed.
Renovation of the existing building would then have proceeded with
minimal impact on AC operations. Under
Option 4, however, staff recommend that renovation of the existing building’s
basement for AC proceed at the same time as renovation of the upper two levels,
(i.e. after completion of the expansion), to benefit from the cost savings
associated with a single tender for renovations. As a result, the AC will not move from its
current leased location until October 2006, when renovations are
completed. Staff
therefore recommend that the AC lease be extended to October 2006.
FINANCIAL
CONSIDERATIONS:
The
project cost estimates for Option 4 of the Markham Village Library Expansion
and Renovation are included as Appendix “D”.
The
project cost estimate for each of the components is listed below:
|
|
Cost Estimate |
|
Sq. Ft. |
|
Cost/ Sq. Ft |
|
|
|
|
|
|
|
New
Construction |
|
$3,571,802 |
|
10,500 |
|
$340.17 |
Replacement |
|
$1,587,397 |
|
5,250 |
|
$302.36 |
Renovation |
|
$2,200,000 |
|
19,560 |
|
$112.47 |
FF&E / IT |
|
$741,405 |
|
|
|
|
Collections |
|
$1,144,600 |
|
|
|
|
Total Cost
Estimate |
|
$9,245,204 |
|
35,310 |
|
|
|
|
|
|
|
|
|
Details
of each component are outlined below.
New
Construction
This cost estimate includes the total
project cost for the new construction to the library of 10,500 square feet
including construction, site work, internal costs and contingency.
The preliminary cost per square foot
allowed in the Development Charge Background Study (DC Study) is $234.69. As outlined in the chart below, the cost per
square foot in the cost estimate for new construction is $340.17. This represents an increase of $105.48 per sf ($340.17 - $234.69) over the DC Study cost per square
foot. Over the 10,500 sf area of the new construction, higher cost per sf results in costs totalling $1,107,557 ($105.48/sf x
10,500 sf) in excess of the DC Study.
|
|
|
|
|
|
|
|
DC Background Study |
||
|
|
Cost Estimate |
|
Sq. Ft. |
|
Cost/ Sq. Ft |
|
DC Study |
|
Cost Est. |
|
|
|
|
(A) |
|
(B) |
|
(C) |
|
(B-C) x A |
|
|
|
|
|
|
|
|
|
|
|
New
Construction |
|
$3,571,802 |
|
10,500 |
|
$340.17 |
|
$234.69 |
|
$1,107,557 |
Replacement |
|
$1,587,397 |
|
5,250 |
|
$302.36 |
|
|
|
|
Renovation |
|
$2,200,000 |
|
19,560 |
|
$112.47 |
|
|
|
|
FF&E / IT |
|
$741,405 |
|
|
|
|
|
|
|
|
Collections |
|
$1,144,600 |
|
|
|
|
|
|
|
|
Total Cost
Estimate |
|
$9,245,204 |
|
35,310 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Thus, of the
$3,571,802 cost for the new construction, $1,107,557 exceeds the preliminary DC
Study average. It is not recommended
that the $1,107,557 be funded from development charges as this may bring the
development charge reserve into a deficit position and may not be fully
recovered in the next DC by-law period.
The balance, $2,464,245 can be funded 90% ($2,217,821) from development
charges, 10% ($246,424) from the General Capital Reserve.
A capital project
totalling $1,807,800 (90% DC: 10% General Capital Reserve) was previously
approved for the Markham Village Library Expansion project. As outlined in the table below, an
additional $1,764,002 is required to fund the new construction component of the
Markham Village Library Expansion. The
$1,764,002 will be funded from DC’s ($590,801), General Capital Reserve
($65,644) and the balance ($1,107,557) from a non-development charge
source.
|
|
|
Cost Estimate |
|
|
90% DC |
10% General |
Excess |
|
|
|
|
|
|
|
|
|
|
|
(A) |
Cost Estimate |
|
|
|
|
|
|
||
|
|
New Construction |
3,571,802 |
|
|
2,217,821 |
246,424 |
1,107,557 |
|
|
|
|
|
|
|
|
|
|
|
(B) |
Less: Prev.
Approved Capital |
|
|
|
|
|
|
||
|
|
Project 5155 |
1,807,800 |
|
Total Funding |
1,627,020 |
180,780 |
|
|
|
|
|
|
|
|
|
|
||
(A)-(B) |
|
Funding Required |
$1,764,002 |
|
|
$590,801 |
$65,644 |
$1,107,557 |
|
|
|
|
|
|
|
|
|
|
Replacement
The cost to
construct the 5,250 of replacement space is $1,587,397 inclusive of construction,
site works, internal costs and contingency.
As part of the 2003 budget, Council approved two capital projects
($488,900), which would enable the Library Administration to move into the
basement of the Markham Village Library.
One project was for the costs associated with relocating the
Administration Centre ($60,000), and the other for the renovation of the
Library basement ($428,900). Both of
these projects were to be funded from the elimination of the operating lease
over a period of approximately 2 years.
The change in the design of the expansion from the south to the north
has resulted in an increased cost associated with the relocation of the Library
Administration Centre. The original
option to the south only required funding for the finishing of the
basement. The current option to the
north requires the construction of an additional 5,250 sf
to replace the programming space being lost in the basement of the existing
facility. This change in scope has
increased the cost of the relocation by $1,158,497 ($1,587,397 – 428,900),
which will require approximately 7 years ($1,587,397 / $237,401) to payback
through the elimination of the operating lease.
Renovation
In the 2004
capital budget, Council approved the renovation of the existing Markham Village
Library at a cost of $2,200,000 with 50% being funded in the 2004 budget and
the balance to be included in the 2005 capital budget.
FF&E
/ IT
The furniture,
equipment and IT cost of
$741,405 is consistent with the preliminary 2004 development
charge background study. This cost
represents the requirements for the 10,500 sq. ft. of new construction
only. Staff are
currently reviewing various options pertaining to the equipment and IT
component of the renovation, and will report back to Council at a later date.
Collections
The collections
cost of $1,144,600 is consistent with the preliminary 2004 development charge
background study. This cost represents
the requirements for the 10,500 sf of new
construction only.
Architect
fees increase due to increase in scope of project.
The
amount of the architectural fees awarded to Shoalts and Zaback was $266,430.
These fees were for an expansion of 10,500 sf and for
the renovation of the 5,250 sq in the basement as defined in the RFP. It was
indicated in the RFP that this project would be completed in November 2004.
The
project recommended in this report consists of an expansion of up to 15,750 sf and renovation of 19,560 sf
and the projected completion date of October, 2006.
The fee proposal submitted by Shoalts and
Zaback provided for a fee calculated on the basis 9% of the increased
construction estimate cost, and 12% of the increased renovation cost estimate.
This amount would cover the architectural fees including structural,
electrical, and mechanical sub-consultants for additional work not included in
the RFP. This amount did not include for the speciality sub-consultants
required for the project.
As
the scope of the project has not been finalized at the time the report was
prepared,
it is recommended that Finance and Asset
Management staff be given the authority to negotiate the additional fees with
the architect based on the final scope of the project and the provisions in the
RFP discussed above.
Once
these negotiations have been completed, it is recommended that the Mayor and
Clerk be given authority to approve the increased fees and to execute the
architect’s agreement.
HERITAGE
AND URBAN DESIGN:
Heritage
and Urban Design staff have reviewed Option 4, and
offer the following observations:
SCHEDULE:
Activity |
Target Completion Date |
Council Approvals |
Schematic Design |
July
– August 2004 |
September 2004 |
Design Development |
September
– October 2004 |
|
Construction Documents |
November
2004 – March 2005 |
|
Tendering |
April
– May 2005 |
June 2005 |
Construction: Phase 1 New |
July
2005 – March 2006 |
|
Construction: Phase 2 Renovation |
April
2006 – September 2006 |
|
Opening |
October
2006 |
|
ENVIRONMENTAL
CONSIDERATIONS:
None.
ACCESSIBILITY
CONSIDERATIONS:
The project will ensure
accessibility requirements of OBC and TOM requirements.
The design will be presented
to the Accessibility Committee for its review and comments.
ENGAGE
21ST CONSIDERATIONS:
A successful Library
expansion will provide a strong community focus and gathering place for the
Markham Village community, which contributes to Markham’s vision as a place of
vibrant and healthy communities.
BUSINESS
UNITS CONSULTED AND AFFECTED:
The Finance, Recreation, and Culture Services Departments have reviewed and
concur with the report and recommendations.
ATTACHMENTS:
Appendix
“A” Response to issues raised at the
Finance and Administrative Committee, March 22, 2004
Appendix “B” Annual Expenses of Current Lease
Appendix “C” Estimated
one-time expenses associated with relocating the Administration Centre to the
Markham Village Library.
Appendix “D” Town
of Markham: Markham Village Library Expansion and Renovation: Project Cost
Estimate
|
|
|
Catherine Biss Chief Executive Officer Markham Public Libraries |
|
Stan
Bertoia, P. Eng. General Manager, Construction and Utilities |
|
|
|
Peter
Loukes, P. Eng. Director, Operations and Asset Management |
|
Jim
Sales Commissioner
of Community and Fire Services |
I:\SENIOR\MV Expansion\Rpt to F & A June 14 04\Markham Village Library
Expansion-June 14 (Final).doc
